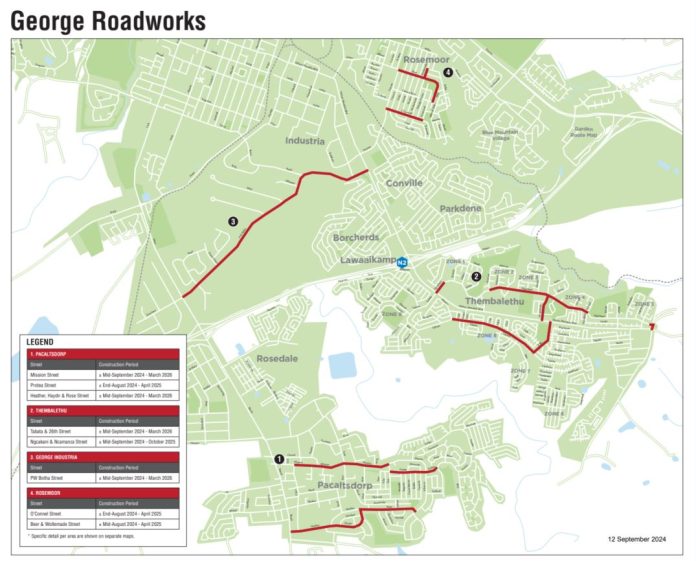

Issued George Municipality, 12 September 2024
George residents will have noted an increase in road works all over town, heralding widespread upgrading of roads used by the GO GEORGE bus service. A list of George Integrated Public Transport Network (GIPTN) infrastructure requirements was assessed by the National Department of Transport which subsequently allocated additional Public Transport National Grant funding of R505 million for some of the projects needed to improve and expand GO GEORGE infrastructure. The infrastructure upgrade projects will include the installation of new bus stops and shelters, road rehabilitation, upgrading of stops, transfer locations and sidewalks, traffic management and road maintenance.
Road rehabilitation
These projects will have most impact on road users. Details of road closures and proposed rerouting will continuously be shared with the public.
Work in Pacaltsdorp will start mid-September, with planned construction timelines as follows:
Mission Street: mid-September 2024 – March 2026
Protea Street: mid-September 2024 – April 2025
Heather, Haydn and Rose Streets: mid-September 2024 – March 2026
In Thembalethu the planned timelines are as follows:
Ngcakani and Ncamanza Streets: mid-September 2024 – October 2025
Tabata and 26th Streets: mid-September 2024 – March 2026
In George Industria work has been ongoing for a few months already in PW Botha Boulevard with completion planned for March 2026.
Rosemoor roadworks have already commenced with planned timelines as follows:
Beer and Woltemade Streets: end-August 2024 – April 2025
O’Connell Street: end-August 2024 – April 2025
In Heather Park a small section of Airway Street will be under construction from end-August 2024 until December 2024.
The Wellington Street intersection improvement in Bo-Dorp have been ongoing since July and should be completed by October 2024.
Streets earmarked for rehabilitation were selected based on physical inspections to identify areas showing critical signs of deterioration. Rehabilitation will entail reparation of severe crocodile cracking, structural failures and low points on roads where stormwater concentrates without catch pits, rightsizing of intersections, road re-alignments and kerbside improvements to conform with universal accessibility requirements.
The George Municipality apologises for the inconvenience and appeals to road users to adapt their travelling patterns (departure times, planning of trips, etc), be patient and exercise caution for the duration of the projects.
Please look out for and adhere to temporary road signage and be aware of roadwork personnel, as well as heavy machinery in the proximity of construction sites.
Details of further road upgrade work will be published as may be necessary
